Serving Greater Greenville

Land Clearing

Forestry mulching and lot clearing around Greenville, planned against the tree protection plan, the critical root zones and the disposal route.

Land clearing with Greenville Tree Removal Team starts with a walk of the parcel and a plan for what stays, across Greenville, SC and out to Gantt, Mauldin, Five Forks, Powdersville and Simpsonville. Twenty years of this work in the Upstate has settled one thing: the expensive mistakes on a clearing job are made in the first hour, when somebody decides where the machines will drive and which trees are being kept.

The two questions that follow are regulatory and logistical. Greenville County Code requires a tree protection plan drawn at the same scale as, and superimposed on, the development site plan or preliminary plat, with its own application, exemptions and tree credit provisions — county instruments that do not reach land inside the city, where a separate ordinance governs. Getting the right one applied to the right parcel is the difference between a clean job and a stop-work conversation.

The logistical question is what happens to the material. Forestry mulching leaves it on the ground as a mulch layer and removes the haul entirely; conventional clearing turns it into loads bound for a gate that prices by the ton or the cubic yard. Both are legitimate, and which is cheaper depends on the stems on your lot, not on a rule of thumb.

Forestry Mulching

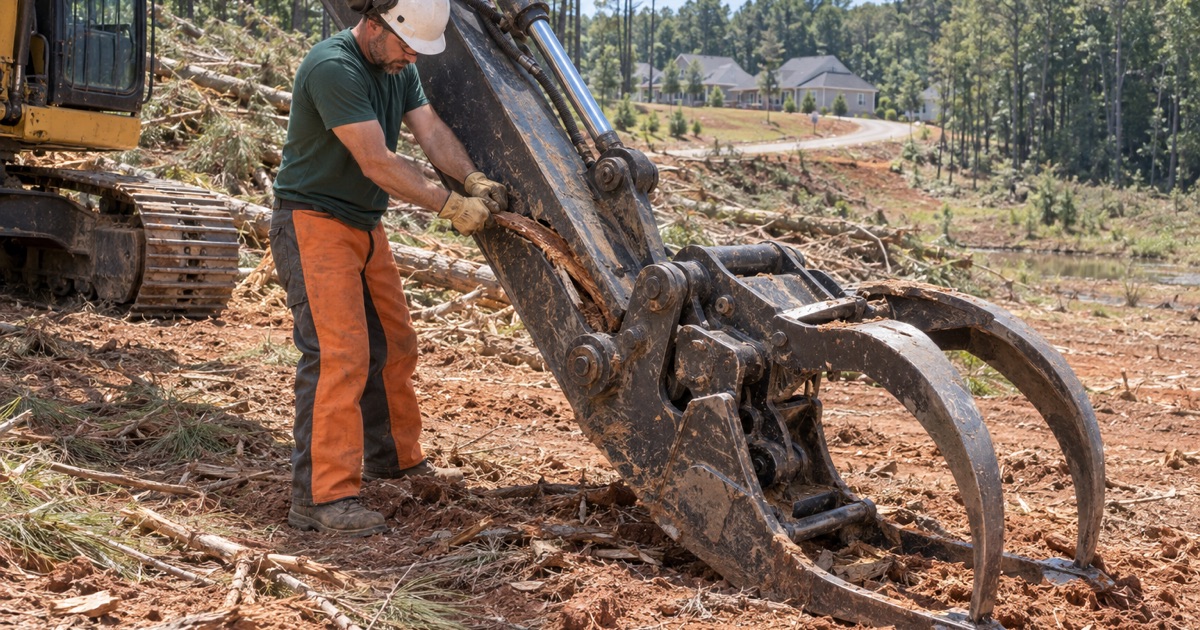

Worker freeing a trapped strip of bark from the lowered grapple arm at a Greenville County lot clearing.

What a Forestry Mulcher Does

A forestry mulcher is a tracked carrier with a rotating drum of fixed teeth that grinds standing brush, saplings and small stems into chips where they stand, in one pass, with no separate cutting, piling or loading step. The material lands as a layer across the worked area. Because nothing leaves the site there is no haul, no tipping fee and no procession of trucks, which is where the cost difference against conventional clearing mostly lives.

Where Mulching Is the Right Tool

Overgrown back sections, fence lines, trail and drive corridors, pasture reclamation, and understory work under a canopy you intend to keep are all natural fits. It is also the honest answer for a wooded lot where the owner wants access and sightlines rather than a bare pad. What it is not is a solution for a single large specimen tree, or for a parcel carrying mature timber above the drum’s working diameter — those are removals, and we price them as such.

The Mulch Layer, Erosion and Regrowth

The layer left behind does real work on Piedmont ground. Pacolet slopes across this region commonly run 15 to 25 percent, and a scraped lot on that gradient loses soil in the first heavy rain in a way a mulched one does not. The layer also suppresses regrowth while it breaks down, though anything with a live root system underneath will eventually come back, so a maintenance pass every couple of years is normal rather than a sign something went wrong.

Conventional Clearing and Where the Material Goes

Grubbing, Stumps and a Buildable Pad

Where something is being built, the requirement is usually a clean pad rather than a mulched surface, which means stumps out or ground well below grade and root mats removed. That is machine time plus material volume, and the volume is what drives the invoice. We say in the estimate whether stumps are ground or excavated and to what depth, because those two words describe jobs that price very differently.

Hauling, Tipping and the Gate Behind the Job

Cleared material becomes a disposal problem the moment it is loaded. Greenville County charges $5.00 per cubic yard for a small vehicle and $32.50 per ton at the tipper, with tree stumps and root mats named on its own schedule and unseparated loads carrying a penalty per ton, and commercial haulers are directed to a specific landfill. The county to the north runs a different gate on a different basis. We price disposal against the site’s actual destination rather than a regional average.

Burning, Chipping and On-Site Options

Some of the volume can often stay: chipping brush for use on the property, retaining usable trunk lengths for a landowner who wants them, or windrowing material at the back of an acreage parcel where that is permitted. Open burning is governed separately and by more than one authority, so we tell you what applies rather than assuming it is available. Every option that keeps material on site takes tonnage off the disposal line.

Protecting What You Are Keeping

Critical Root Zones and Where Machines May Not Go

The governing definition of a critical root zone in the city is a circle whose radius in feet equals the trunk diameter in inches, so a 40-inch tree carries a 40-foot protected radius. Inside that circle, driving, parking, stockpiling and trenching are all forms of damage, and compaction is the one nobody sees happen. Marking those circles before the first machine moves is the cheapest step in a clearing job and the one most often skipped.

Tree Protection Fencing That Actually Complies

Where protection is required, the city’s specification is particular: fencing at least four feet high, of wood or metal, completely encircling the critical root zone before earth is disturbed and remaining for the duration, with silt fencing expressly not acceptable as tree protection. Signs of at least one foot by 1.5 feet reading TREE PROTECTION ZONE: KEEP OUT are required in English and Spanish on all sides and every 300 linear feet. Getting this wrong is a correctable failure before work starts and an expensive one afterwards.

Mitigation, Tree Credit and Canopy Replacement

On development and land-disturbing activity inside the city, removal or injury of trees six inches in diameter at breast height or greater triggers replacement or mitigation equal to or greater than the cumulative diameter removed, with a fee-in-lieu route that is capped per acre and prorated by parcel size. Heritage trees carry an additional per-caliper-inch assessment on top of that. Counting the trees before they come down is how a clearing budget avoids a mitigation bill nobody modeled.

Planning a Clearing Job Before the Machines Arrive

The Walk, the Marking and the Written Scope

We walk the parcel with you, mark what stays, identify the access route, note the wet ground and the slope that will decide where a machine can work, and write all of it down. The scope names the area in defined boundaries, the treatment for each part of it, the stump treatment and the disposal route. Ambiguity on a clearing job gets resolved by whoever is holding the controls, which is not where that decision belongs.

Utility Locates and Buried Surprises

South Carolina 811 goes in before ground is broken and the marks come back in working days, which sets the earliest realistic start. Public utilities are located through that process; private lines are not, and older Upstate parcels carry plenty of them — abandoned field lines, irrigation mains, a gas run to a barn, low-voltage cable to a gate. Walking those with us during the estimate is worth more than any allowance we could put in the price.

Access, Slope and What the Site Will Take

A parcel that reads as straightforward on a map can be awkward on the ground: a single narrow entry, a soft crossing, a bank too steep to work across safely. Tracked equipment handles a great deal here, and there is still a point at which the answer is a smaller machine and more days. We would rather tell you that at the estimate and price it honestly than start on optimism and come back for more.

  • 20+ Years in the Upstate
  • Free Estimates
  • Written Tree Condition Reports

Good to know

Frequently Asked Questions

What does forestry mulching leave behind?

A layer of shredded wood and brush spread across the area that was cleared, usually a couple of inches deep where the growth was light and considerably more where it was heavy. Stumps are cut low but remain unless you have asked for grinding as well. The layer suppresses regrowth for a season or two, holds soil on slope, and breaks down in place, which is the whole reason there is no haul cost.

Is mulching cheaper than conventional clearing?

Usually, and the saving is almost entirely disposal. Conventional clearing pushes material into piles, loads it and hauls it to a gate that charges by the ton or the cubic yard, and that transport is often the largest single line on the invoice. Mulching removes the haul, the tipping fee and most of the truck traffic. Where it loses is on heavy timber, because a mulcher is built for stems up to a certain diameter and large trunks still have to be handled as removals.

Do I need a permit to clear my own land?

It depends on where the parcel is and what you are doing with it. Clearing tied to development or land-disturbing activity is regulated in most of the jurisdictions in this service area, often with a land disturbance permit, a tree protection plan drawn on the site plan, and mitigation for trees above a stated diameter. Clearing overgrowth on an established residential lot is frequently outside that, but the line between the two is local and worth checking before a machine arrives.

Can you clear right up to the property line?

To it, yes. Past it, no, and the risk of crossing is not worth the convenience. South Carolina Code Section 16-11-615 provides treble damages for trees cut without the owner's consent, with value established by a registered forester, so a mistaken boundary on a clearing job is an expensive category of error. Where the line is uncertain we ask for a survey or stay well inside it and say so in the estimate.

How long does it take to clear an acre?

Anywhere from most of a day to several days, driven by stem density, average stem size, slope and how much of the acre a machine can actually reach. Light brush and saplings go quickly. An acre carrying mature timber, a wet drain or a slope too steep to work across is a different job, and we walk the ground before quoting rather than pricing by the acre off a map.

Will you save specific trees on the lot?

Yes, and it works best when that decision is made before anything starts. Trees to keep get marked, and the ground inside their critical root zone gets fenced so machines never drive, park or stockpile there. Compaction and root severance during clearing are what kill saved trees a year or two later, long after everyone has decided the job went well.

Do you handle the 811 locate on a clearing job?

Yes. South Carolina 811 gets public buried utilities located and marked before the ground is disturbed, and clearing counts, particularly where stump grinding or grubbing follows. Locates take working days, which is normally why a clearing start date is a week out. Private lines that no utility marks — irrigation, invisible fencing, a gas run to an outbuilding, an old field line — are worth walking with us beforehand.
